Malagarasi Hydropower Project49.5 MW · Kigoma Region · Tanzania

Civil works are under way at the headworks, the headrace culvert, the powerhouse and the permanent camp at the same time, with day and night shifts on the concrete fronts. Main electro-mechanical equipment is in manufacture. Milestones below are as at 2 October 2026.

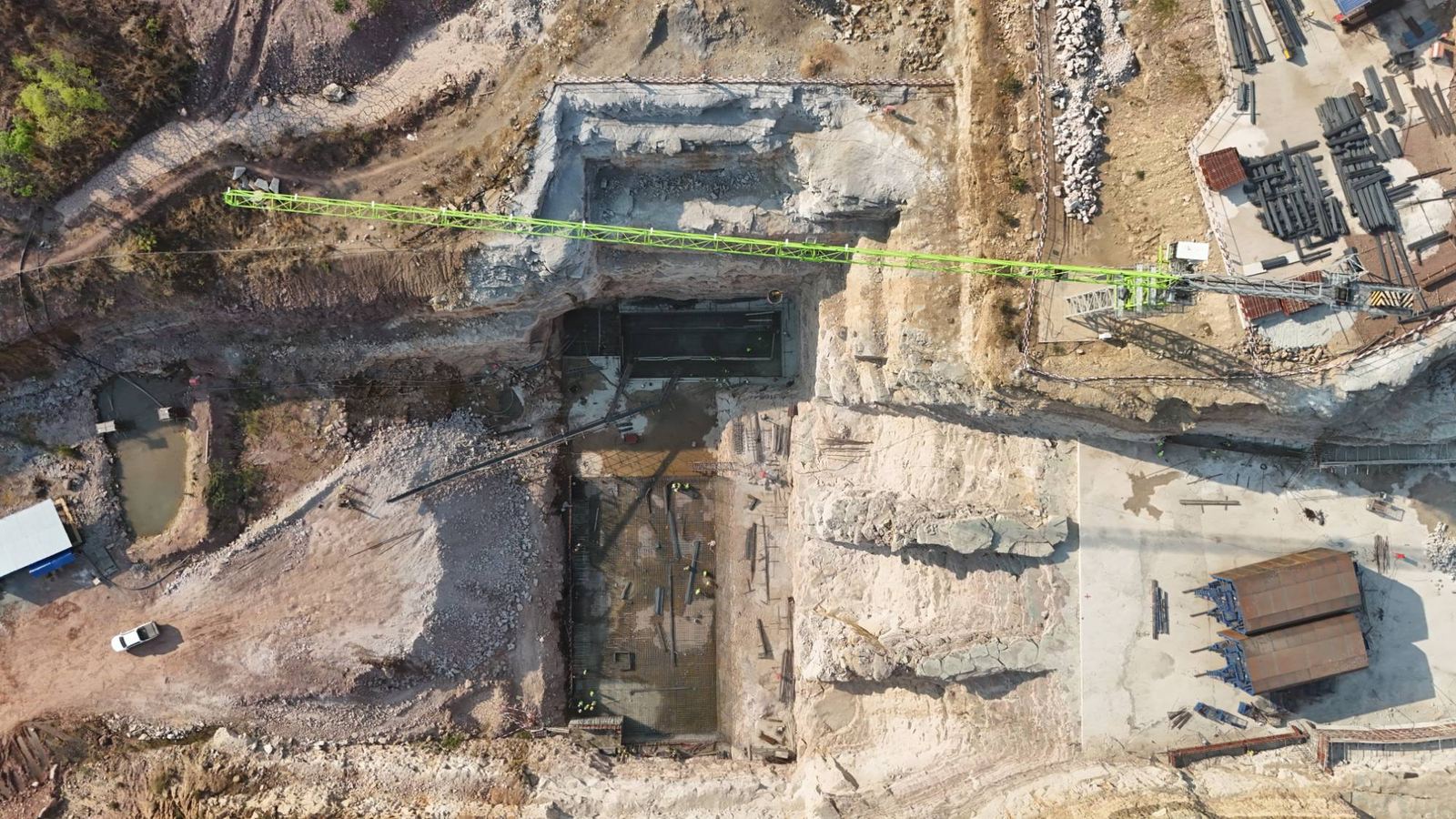

Drone view looking down into the powerhouse pit, with the tower crane jib across it
The powerhouse pit from above on the day of the first pour: sump pit (top) and the unit 2–3 foundation slab, 2 October 2026

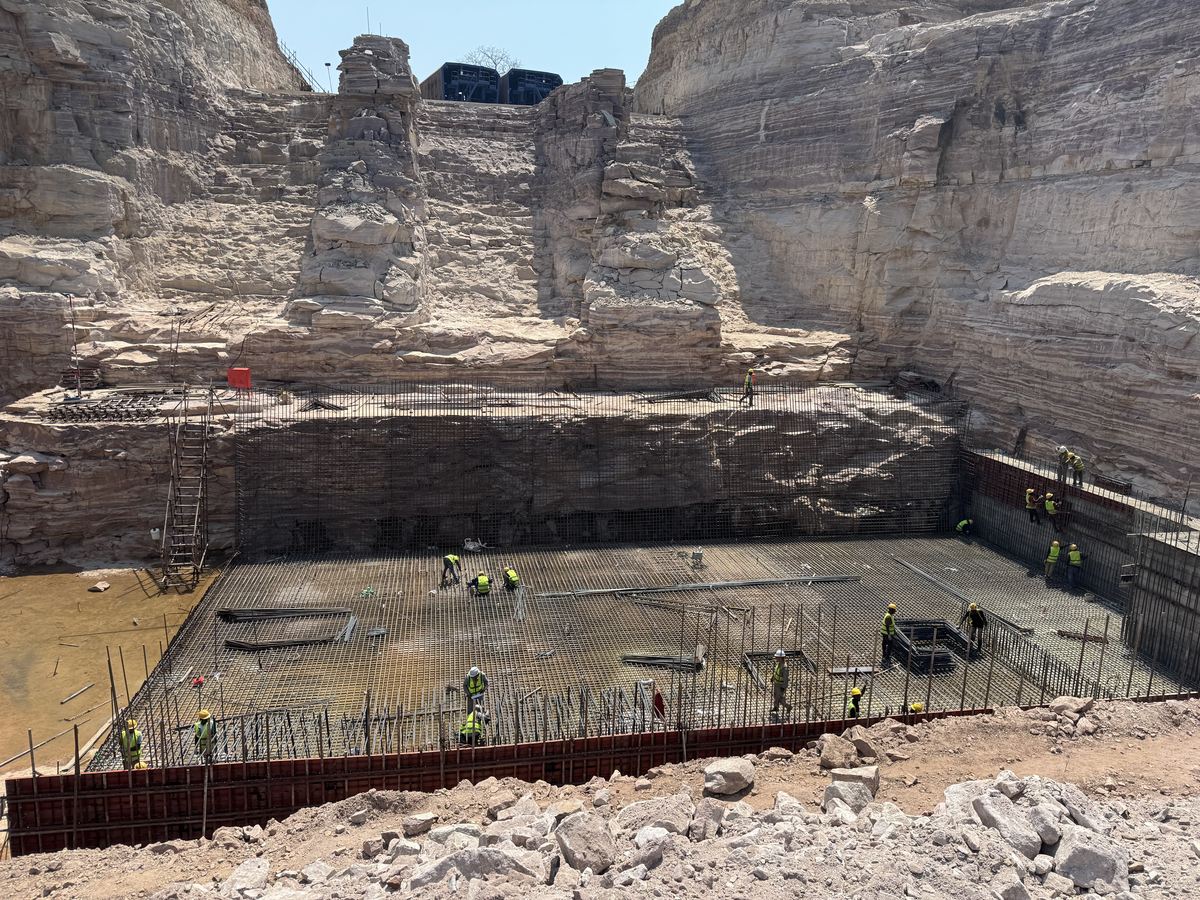

Workers on the reinforcement mat of the powerhouse foundation slab below the rock walls
Unit 2–3 foundation slab with its reinforcement in place, 2 October 2026

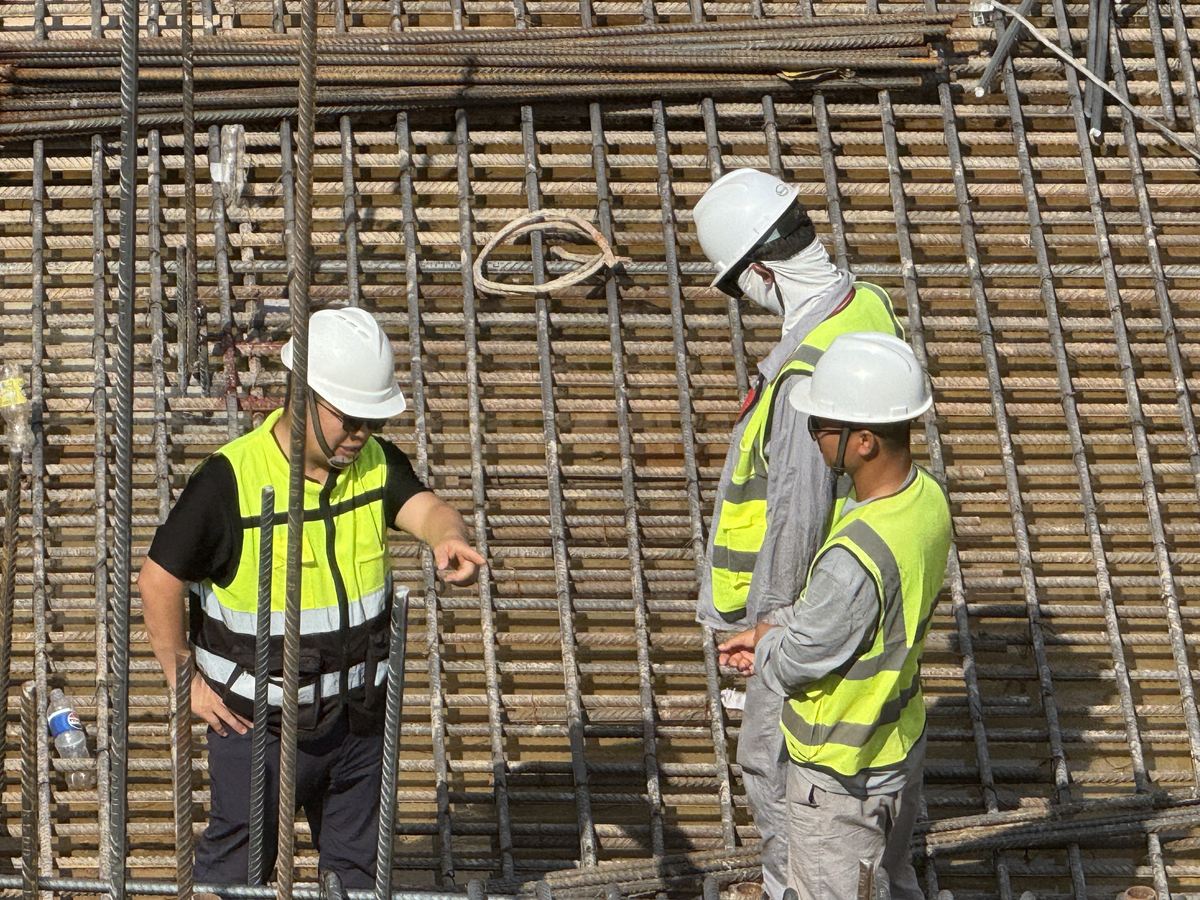

Engineers in hard hats inspecting the reinforcement mat
Checking the reinforcement before the pour, 2 October 2026
  • EPC contract for Lot 1 signed.

  • Site mobilisation. Access road to the site improved, village road widened and levelled, temporary camp and site office established.

  • Diversion channel, cofferdams and powerhouse excavation. Aggregate crushing and concrete batching plants commissioned. Permanent camp construction begins.

  • River closure of the main channel achieved; the Malagarasi now flows through the diversion channel.

  • Upstream cofferdam clay core closed (14 Aug); first blast for the dam foundation (18 Aug); dewatering of the dam pit begins (21 Aug); headrace culvert concreting continues with night pours.

  • Upstream cofferdam raised above EL 834 m and the dam pit kept dry by three pumps. Foundation excavation for dam blocks 7–9 under way and the cut-off trench being cleaned. Culvert bedding concrete cast bay by bay, with formwork now at chainage 0+930–0+970 and backfill concrete being placed at the downstream transition into the surge tank. Powerhouse sump-pit floor reinforcement accepted and the unit 2–3 foundation slab being reinforced; aggregate and batching plants running to feed the pours.

  • First structural concrete of the powerhouse placed in the sump pit (EL 785.4–786.9 m).

Excavator loading a dump truck in the dam foundation

Headworks

River closed and both cofferdams in place, the upstream one above EL 834 m. With three pumps keeping the pit dry, the foundation of dam blocks 7–9 is being excavated and the cut-off trench cleaned.

Dam foundation excavation, 30 September 2026

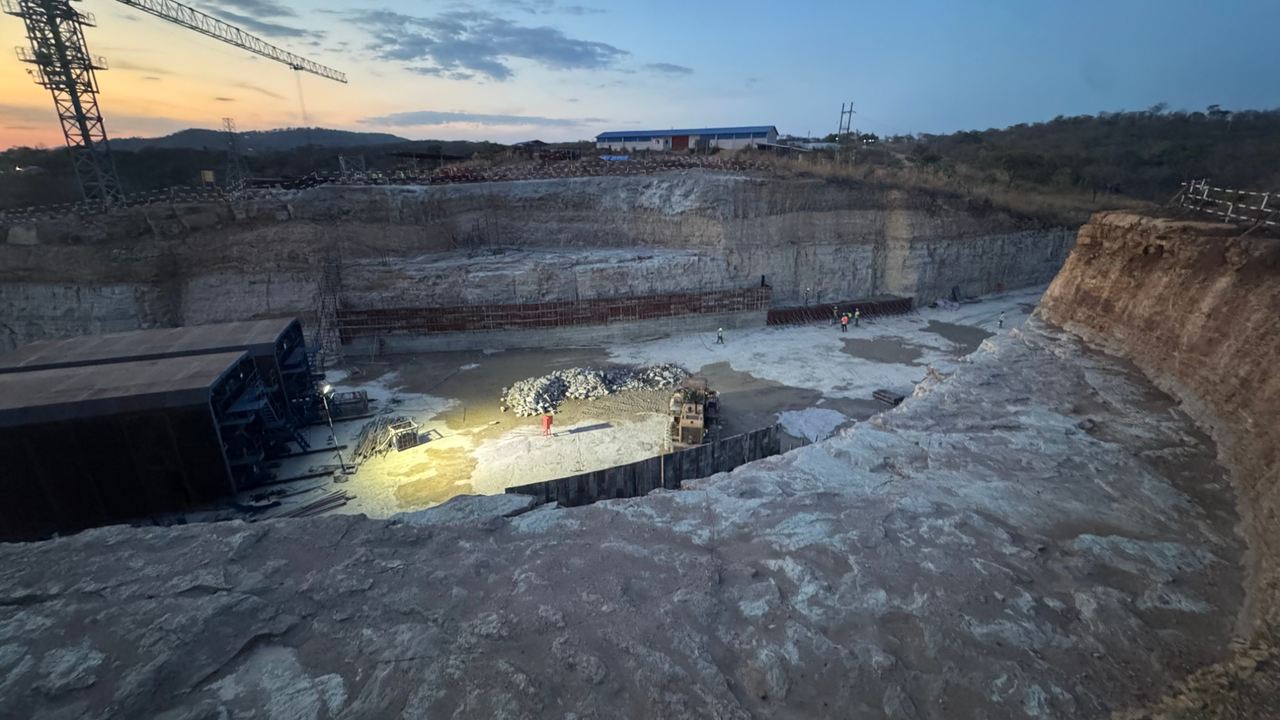

Downstream end of the headrace culvert at the surge tank at dusk, with two steel formwork trolleys

Headrace culvert

Excavation of the 1.5 km alignment complete; bedding concrete cast bay by bay, with formwork now at chainage 0+930–0+970. At the downstream end, backfill concrete is being placed where the culvert meets the surge tank, beside the two steel formwork trolleys for the twin bores.

Downstream end of the culvert at the surge tank, 30 September 2026

A red concrete skip being lowered by crane into the reinforced sump pit, with workers guiding it

Powerhouse

Excavation and slope support complete. The first structural concrete was placed in the sump pit on 2 October 2026; the foundation slab for units 2 and 3 is being reinforced, ahead of its first pour.

Concrete skip lowered into the sump pit for the first pour, 2 October 2026

Employer's Camp B buildings under construction

Permanent camp

Camps A, B and C, site office and gymnasium for the Employer: structures up, roofing and finishing works in progress. Expansion of the workers' camp began at the end of September, with nine housing units under construction.

Employer's Camp B, April 2026
